Direct answer: Trailer shipping time from China to Africa usually needs a planning window of about 20 to 45 days at sea, depending on the Chinese port, African destination port, vessel schedule, cargo mode, and transshipment route. Buyers should also add time for factory completion, inland delivery to the China port, export loading, customs documents, port release in Africa, and final inland delivery.
The sea voyage is only one part of the timeline. A semi-trailer can be delayed before loading if production photos, booking, bill of lading details, or lashing plans are late. It can also be delayed after arrival if the broker, tax payment, terminal fee, inspection, or tractor delivery is not ready.

Quick Buyer Decisions
- Ask for a shipment timeline before paying the balance.
- Separate production time from sea transit time.
- Confirm whether the trailer moves by roll-on/roll-off, breakbulk, flat-rack, or another method.
- Check whether the route has direct sailing or transshipment.
- Ask for cut-off date, estimated time of departure, and estimated time of arrival.
- Prepare African port clearance before the vessel arrives.
- Add inland delivery time after port release.
- Treat all time estimates as planning windows, not guarantees.

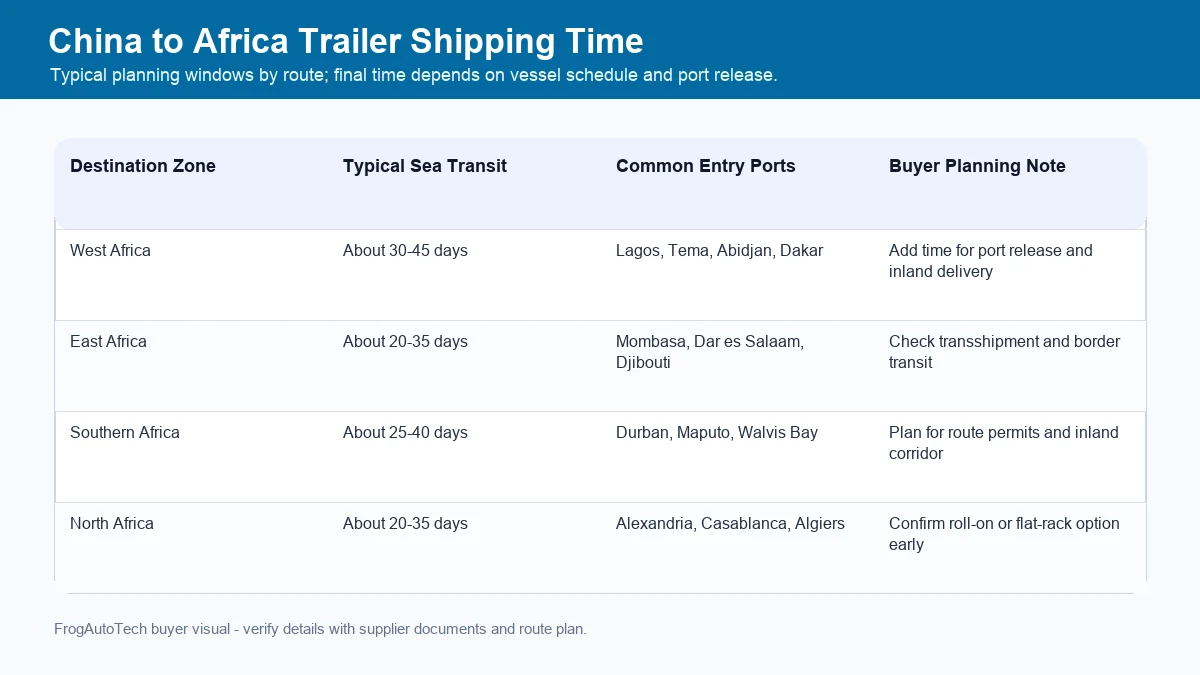

Typical Shipping Windows by African Region
Trailer routes vary by vessel schedule. The same trailer may ship faster one month and slower the next month. Port congestion, transshipment, weather, customs checks, and carrier changes can also affect the final date.

| Destination region | Common destination ports | Typical sea-transit planning window | Buyer note |
|---|---|---|---|
| West Africa | Lagos, Tema, Abidjan, Dakar, Douala | About 30 to 45 days | Add time for port release and inland delivery |
| East Africa | Mombasa, Dar es Salaam, Djibouti | About 20 to 35 days | Check transshipment and border transit for inland countries |
| Southern Africa | Durban, Maputo, Walvis Bay | About 25 to 40 days | Confirm route permits and final delivery corridor |
| North Africa | Alexandria, Casablanca, Algiers | About 20 to 35 days | Confirm cargo mode and port acceptance early |
These windows are conservative planning ranges. The final time must come from the freight forwarder or carrier booking. For example, one West Africa sailing may be direct, while another may wait at a transshipment hub. That difference can change the schedule by several days or more.
The UNCTAD Review of Maritime Transport 2024, accessed June 20, 2026 discusses maritime trade, shipping networks, and disruptions that affect global transport. For trailer buyers, the lesson is practical: do not plan only from a generic port-to-port number. Confirm the actual vessel route.
Data point: UNCTAD's Review of Maritime Transport 2024 says global maritime trade grew by 2.4% in 2023.
Data point: The same UNCTAD review says over 80% of world trade volume is carried by sea.
Data point: UNCTAD reported that the Shanghai-West Africa average freight rate jumped 137% from January to July 2024.
Timeline From Factory to African Fleet Yard
The buyer should plan the full chain, not only the ocean leg.
| Stage | What happens | Common buyer risk |
|---|---|---|
| Production finish | Factory completes trailer and final inspection | Final spec photos are not checked |
| Inland delivery in China | Trailer moves from factory to port or loading yard | Port cut-off is missed |
| Export booking | Forwarder confirms cargo mode and vessel | Wrong cargo dimensions or weight |
| Loading | Trailer is lashed, blocked, and photographed | No condition proof before shipment |
| Ocean transit | Vessel moves to African port, sometimes via hub | Transshipment wait changes ETA |
| Arrival notice | Broker prepares clearance and port fees | Documents are not ready |
| Port release | Trailer is inspected and released | Tax, terminal fee, or document mismatch |
| Inland delivery | Trailer is towed or transported to buyer yard | Tractor, permit, or road plan is late |
If the buyer has not confirmed the trailer specification yet, read How to Choose Trailer Suspension for the African Market and Trailer Axle Load Capacity for African Roads before shipment. It is much cheaper to fix a specification before production than after arrival.
West Africa Shipping Time
West Africa routes often need a longer planning window because ports may be farther from China and may use transshipment depending on vessel schedule. Lagos, Tema, Abidjan, Dakar, and Douala are common import gateways for semi-trailers and project cargo.
For Nigerian buyers, How to Ship a Trailer from China to Lagos Port gives a closer look at documents, freight terms, and buyer checks. It is useful if the cargo is going through Lagos and the buyer wants a route-specific checklist.
West Africa buyers should ask:
- Is the sailing direct or transshipment?
- Which China port will load the trailer?
- Is the trailer going by roll-on/roll-off, breakbulk, or flat-rack?
- What is the estimated time of departure?
- What is the estimated time of arrival?
- When will the bill of lading draft be ready?
- Who handles destination port clearance?
East Africa Shipping Time
East Africa routes often use ports such as Mombasa, Dar es Salaam, and Djibouti. The sea leg may be shorter than many West Africa routes, but inland delivery can be complex. Uganda, Rwanda, Burundi, Ethiopia, South Sudan, and parts of eastern Congo may need border transit after port release.
The article on Import Semi-Trailer to Uganda via Mombasa explains why inland-country buyers need port clearance, transit documents, border coordination, and road-ready trailer specs. A short sea route does not always mean a short delivery schedule.
If the trailer is moving to Ethiopia through Djibouti, see Import Trailer to Ethiopia from China for corridor planning and document checks.
Southern Africa Shipping Time
Southern Africa shipments may use Durban, Maputo, Walvis Bay, or other ports depending on the buyer country and route. The sea leg can be moderate, but final delivery may require permits, inland tractors, corridor checks, and customs coordination.
For Mozambique buyers, Import Trailer to Mozambique via Maputo Port gives a specific port-route view. If the buyer is moving mining or construction trailers inland, plan the route before the vessel arrives.
The World Bank Logistics Performance Index, accessed June 20, 2026 focuses on supply-chain performance and logistics reliability. For trailer buyers, reliability is often lost at the handover points: factory to port, vessel to port, port to broker, and broker to inland delivery.
Cargo Mode Changes the Timeline
Not all trailers ship the same way. The cargo mode affects booking time, port handling, lashing, cost, and schedule.
| Cargo mode | When it may be used | Timeline impact |
|---|---|---|
| Roll-on/roll-off | Trailer can be moved on wheels or towed | May be efficient if vessel space is available |
| Breakbulk | Oversized or non-containerized trailer cargo | Needs lashing plan and port handling |
| Flat-rack | Some trailer parts or smaller units | Needs container availability and loading plan |
| Containerized parts | Spare parts or knocked-down components | Can use container schedules, but assembly is needed |
For heavy lowbed trailers, cargo dimensions matter. A Lowbed Semi-Trailer or the 13 m Heavy-Duty Low Bed Semi Trailer with Hydraulic Ramps should be checked by length, width, height, axle layout, and ramp design before freight booking. A small dimension error can delay the booking or change the shipping method.

Need a realistic shipping plan before payment?
Share destination port, trailer type, cargo dimensions, shipping term, and required delivery month before final booking.
Documents That Protect the Timeline
Late documents can delay the shipment even when the trailer is ready. Ask for a document checklist before final payment.
| Document | Why it matters |
|---|---|
| Commercial invoice | Supports customs value and buyer-seller record |
| Packing list | Describes cargo, dimensions, and quantity |
| Bill of lading draft | Confirms shipper, consignee, notify party, cargo name, and route |
| Trailer specification sheet | Helps broker and buyer confirm cargo details |
| Loading photos | Shows condition before shipment |
| Chassis or VIN information | Helps identify the exact trailer |
| Insurance document if used | Supports claim process if damage happens |
If you are still deciding between CIF and FOB, read CIF vs FOB Trailer Shipping to Africa. The shipping term changes who controls booking, freight cost visibility, and some communication with the forwarder.

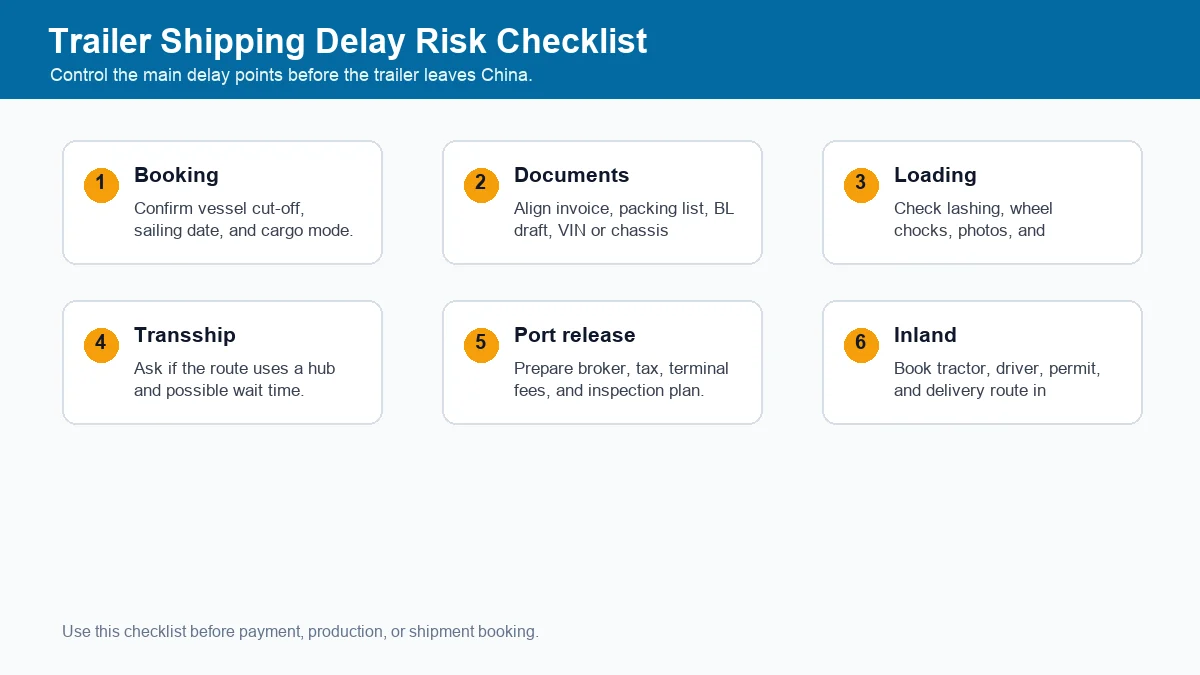

Delay Risks and How to Reduce Them

| Delay point | Cause | Buyer action |
|---|---|---|
| Production delay | Parts, paint, rework, or spec change | Freeze the drawing before production |
| Booking delay | Wrong dimensions or late balance payment | Confirm cargo data early |
| Port cut-off missed | Trailer arrives late at China port | Ask for port delivery photos and dates |
| Document mismatch | Company name, consignee, or cargo name differs | Review bill of lading draft before release |
| Transshipment wait | Vessel route uses a hub | Ask if route is direct or transshipment |
| Destination port delay | Broker, fees, inspection, or congestion | Prepare broker before arrival notice |
| Inland delivery delay | No tractor, permit, or route plan | Book final delivery before port release |
The World Bank Transport overview, accessed June 20, 2026 highlights the importance of resilient transport systems. For trailer buyers, resilience means building margin into the timeline. A tight project schedule should not depend on the fastest possible sailing date.
FAQ
Is trailer shipping time from China to Africa always 30 to 45 days?
No. Some East Africa or North Africa routes may be shorter. Some West Africa routes may take longer, especially with transshipment, port delay, or missed cut-off. Use 20 to 45 days as a planning window, then confirm the actual booking.
Does CIF shipping arrive faster than FOB?
Not always. CIF and FOB are freight terms, not speed guarantees. CIF may be easier for some buyers because the supplier arranges freight. FOB may give the buyer more control if they have a strong forwarder.
When should I prepare port clearance documents?
Prepare before the vessel arrives. Waiting until arrival can add days. The broker should review invoice, packing list, bill of lading draft, and cargo description early.
What causes the most avoidable delay?
Document mismatch is one of the most avoidable delays. Company name, consignee, notify party, cargo name, chassis number, and destination details should be checked before the bill of lading is released.
Final Buyer Advice
Trailer shipping time from China to Africa should be planned as a full chain. Production, inland China delivery, booking, loading, ocean transit, port release, and final inland delivery all matter.
Ask for a route-specific timeline before final payment. Then track the shipment by document stage, vessel stage, and destination release stage. That gives the buyer a realistic delivery plan instead of only a hopeful ETA.
